Skip to main content

Ringwood Road, Poole (Hunt Road to Mountbatten roundabout)

Major work on bus, walking, cycling and road improvements including resurfacing along Ringwood Road between Hunt Road (Parkstone) and Mountbatten roundabout (Alderney/West Howe) started in September 2024. It forms part of a sustainable travel route planned between Poole, Ferndown and Wimborne which includes the new improvements on Wimborne Road, Leigh Road and Ringwood Road in Ferndown and St Mary’s Road in Poole.

CGI for Ringwood Road
An artist’s impression of the proposed improvements on Ringwood Road looking south towards Newtown Business Park.

What's being delivered

  • A new northbound bus lane between St Clements Road and Old Wareham Road roundabout
  • A new southbound bus lane from Mannings Heath Mini Roundabouts to Old Wareham Road roundabout
  • 4.5km of road resurfacing from Hunt Road to Mountbatten roundabout
  • Improving 1.8km of pavements on the western side of Ringwood Road between Hunt Road junction and Mountbatten roundabout including upgrading sections into shared paths for walking, wheeling and cycling
  • A new 2.7km two-way cycle track on the eastern side of Ringwood Road, between Hunt Road junction and Mountbatten roundabout. This includes sections of shared path for walking, wheeling and cycling
  • New and improved toucan, zebra and parallel crossings to enable east-west connectivity for people walking, cycling and wheeling along Ringwood Road. Click here for further details
  • Major improvements to Sea View Road junction to improve the traffic flow for buses and motorised vehicles. A new dedicated bi-directional cycle crossing and new pedestrian crossing will be installed across Sea View Road
  • 23 side road junction upgrades including improvements to bus, walking and cycling provision
  • Upgraded bus stop shelters at 19 locations; five bus stops relocated. Click here for further details
  • Improvements to Old Wareham Road roundabout including wider footways and new crossings on all arms
  • Removal of dedicated right-turn filter lanes into Balston Road and Albion Close. Vehicles will still be able to turn right
  • Removal of dedicated right-turn filter lane into Rossmore Road. The northbound lane will be widened so that vehicles can still turn right and northbound traffic able to pass stationary right-turning traffic
  • Several trees will be removed between Old Wareham Road roundabout and Sea View Road. New and additional trees and landscaping will be planted as part of the final layout
  • To support the improvements, the speed limit between Alderney roundabout and Mountbatten roundabout has been reduced to 30 mph to improve safety.

Detailed plans:

Detailed general arrangement drawings of the plans on Ringwood Road:

For any problems interpreting the plans please email transformingtravel@bcpcouncil.gov.uk.

Work phases

Phase one

The first phase of work on Ringwood Road took place from 2 September 2024 until spring 2025 at two locations on Ringwood Road: Mountbatten roundabout to Alderney roundabout and at Sea View junction.

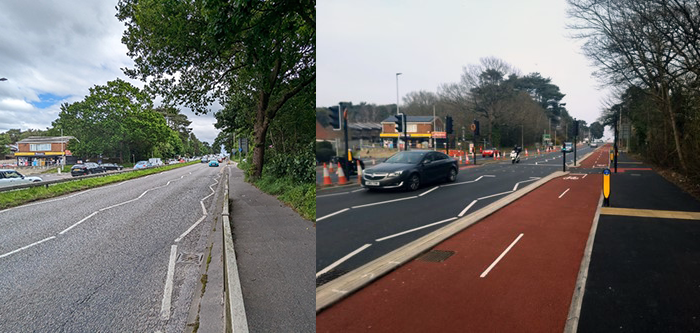

The left is Ringwood Road before the works, and the right is after the works
Stretch between Alderney and Mountbatten roundabouts, before and after works.

Phase two north - Alderney roundabout to Mannings Heath Mini roundabouts

This phase of work was largely completed between February 2025 and May 2025.

Overnight carriageway surfacing and line marking

Overnight carriageway surfacing and line marking will require the closure of Ringwood Road from Alderney Roundabout to Herbert Avenue.

This work will happen during the week of 16 February 2026, between the hours of 7pm and 5am the next morning (Monday to Friday only). Work will take around 5 nights to complete.

To minimise disruption, the work will happen on a rolling programme along the closure area, starting from the north and working south. We apologise for the inconvenience and disturbance these works will cause.

Work needs to be carried out during unsociable hours in order to minimise the impact on access for the hospital and other organisations during opening hours. All roads will reopen outside of surfacing work hours, including the weekend.

Ringwood Road will be closed each evening between Alderney roundabout and Herbert Avenue so that the work can be carried out safely. Please see the map below for the surfacing works area and planned phases.

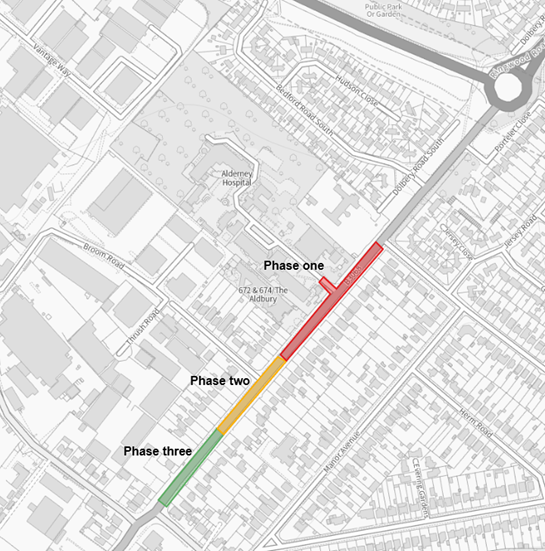

A map showing colour coded phases of planned overnight resurfacing works.

Affected driveway access for properties in the resurfacing area

Properties within the coloured areas of the map will not be able to access driveways by vehicle, or park on the road, between the hours of 7pm and 5am each night.

Vehicles parked on the road will need to be removed by midday on days where work is being carried out that night or they may risk being towed.

If you need your vehicle during the hours of work, please park outside the closure area for that evening.

It is currently anticipated that access to Broom Road will be maintained, except for the night of 17 February 2026.

Our contractors are also working directly with Alderney Hospital and The Aldbury care home to keep them informed about access restrictions.

Properties that will be unaffected

Properties between Alderney roundabout and Alderney Avenue, outside the coloured works area on the map, will have access to their driveways.

Alderney Avenue, Bedford Road South, Dolbery Road South, Hudson Close, and Portelet Close will still be accessible from Alderney roundabout.

Diversions and special access requirements

Diversion routes will be indicated by signs along the road. We will maintain access routes for pedestrians, cyclists and emergency services.

If you have any special medical access requirements during the road closure hours, please let our contractor M Group Highways know as soon as possible via email: comms.ringwoodroad@mgroupltd.com

For more information about these improvements please visit the Ringwood Road scheme webpage

Bedford Road South Dry Basin and Landscaping

Work is underway to install dry-basins to assist with surface water drainage verge at Bedford Road South. Tree planting and landscaping at Bedford Road South and Dolbery Road South will take place during the next planting season following the completion of these works.

Phase two south - Hunt Road to Balston Road

The following sustainable travel improvements have been delivered between Hunt Road and Balston Road:

  • Two-way cycle path on the eastern side of Ringwood Road between Balston Road and Hunt Road, linking into previously constructed cycle paths to the north
  • A new parallel crossing across Ringwood Road, just south of Haymoor Road, with associated areas of shared use path upon approach
  • A new toucan crossing across Ringwood Road, just north of Dale Road, with associated areas of shared use path upon approach
  • The pedestrian refuge on Ringwood Road just south of Dorchester Road junction is being upgraded to a toucan crossing
  • Junction tightening at Haymoor Road
  • Junction tightening at Dale Road with pedestrian refuge being removed
  • Junction tightening at Kinson Pottery
  • Two-way cycle path on the eastern side of Ringwood Road between Balston Road and Parkstone Heights, linking into previously constructed cycle paths to the north and south.
  • Haymoor Road (southbound) bus stop to be relocated further south and shelter upgraded
  • Dale Road (northbound) bus stop outside no. 192 Ringwood Road to be relocated to outside Nos 196 and 198 Ringwood Road, and shelter upgraded
  • Dale Road (southbound) bus stop to be repositioned and shelter upgraded
  • Footway surfacing
  • Carriageway surfacing
  • Improvement to street lighting.

A small amount of remedial work is still being carried out on this section.

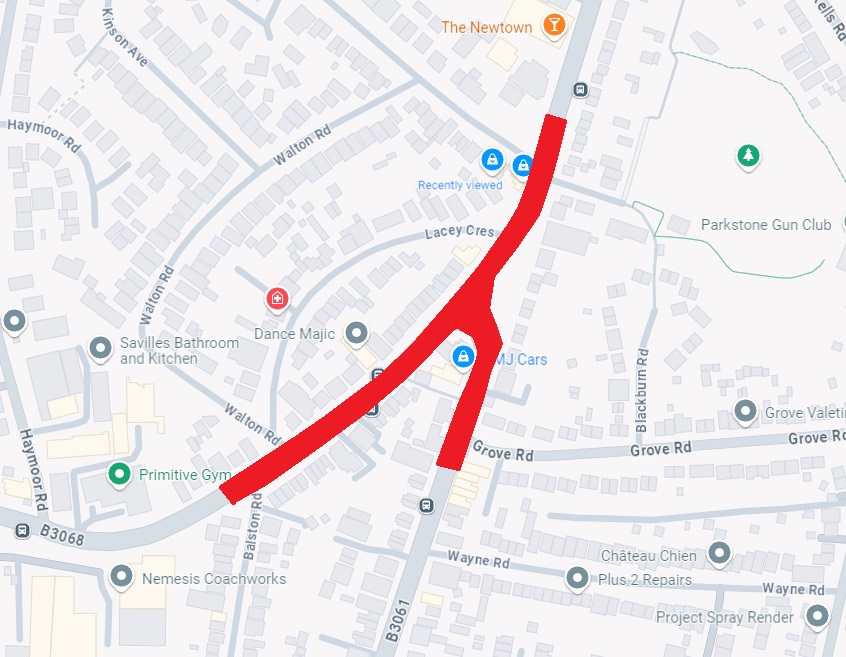

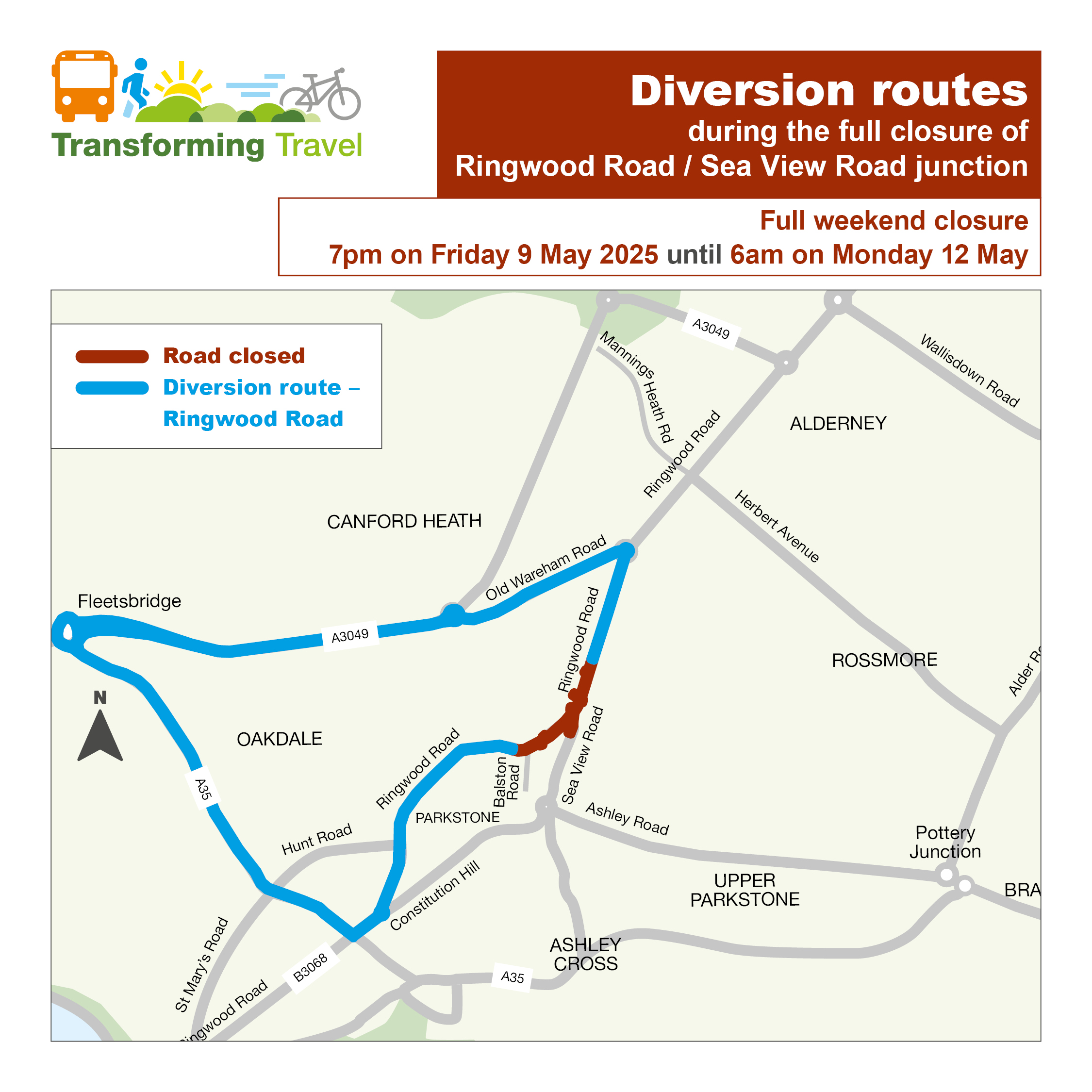

Phase three - Old Wareham roundabout to Sea View junction

Work started on 14 April 2025 and is anticipated to last until early spring 2026. Work is being carried out using temporary road narrowing - traffic flow will still be two-way.

Overnight roadworks will be taking place on Ringwood Road, and side road junctions, between just north of St Clements Road and just south of Rosemary Road.

Overnight carriageway surfacing starts on the night of 9 Feburary and be carried out between 7pm and 5am the following morning. Work will take about 7 nights to complete (Monday-Friday only). To minimise disruption, we will complete the surfacing on a rolling programme along the closure area. We apologise for the inconvenience and disturbance these works will cause.

Surfacing work will be carried out between St Clements and Rosemary Road, and in order to carry out the work safely, Ringwood Road will be closed each evening between Old Wareham Road Roundabout and St Clements Road. Please see the map below for the surfacing works area, and details below for all access arrangements.

Map

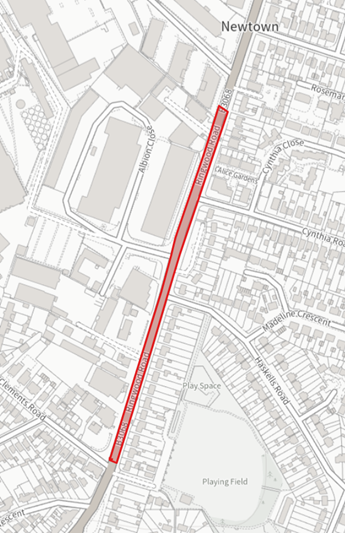

A road map of the area of Ringwood road that surfacing will be completed on.

Properties within the red area of the map will not be able to access driveways by vehicle, or park on the road, between 7pm and 5am each night. Vehicles parked on the road will need to be removed by midday on days where work is being carried out that night or they may risk being towed. If you need your vehicle during the hours of work, please park outside the closure area for that evening.

Properties between Old Wareham Road roundabout and St Clements Road outside the red works area on the map will still have access to their driveways. Access will be available for Tesco, Albion Close, and Co-Op Funeral Care, as well as Haskell Rec Car Park.

Work needs to be carried out during unsociable hours in order to minimise the impact on access for residents and businesses during opening hours. All roads will reopen outside of these hours (including the weekend).

Signed diversion routes will be in place, Pedestrian, cyclist and emergency service access will be maintained.

Surfacing works up to and including Old Wareham Road roundabout will be carried out later in the works programme.

The following sustainable travel improvements are being constructed between Old Wareham roundabout and Sea View Road junction:

  • A new northbound bus lane between St Clements Road and Old Wareham Road roundabout
  • Footway on the western side to be upgraded to shared use path from Old Wareham Road to St Clement’s Road
  • New two-way cycle track on the eastern side of Ringwood Road from Old Wareham Road roundabout to Sea View junction linking with those sections already complete to the south.
  • Crossing improvements
  • Crossing outside no 223/225 Ringwood Road to be upgraded
  • Crossing adjacent to Cynthia House to be relocated slightly further north, closer to Tesco Express
  • Zebra adjacent Rosemary Road – to be removed
  • Upgraded bus stop shelters
  • 4 bus shelters upgraded, remaining in same location
  • Tesco bus stop (southbound) relocated to adjacent to Cynthia House
  • All bus laybys are being removed
  • Side road junction enhancements
  • Removal of the dedicated right-turn filter lane into Albion Close. Vehicles will still be able to turn right
  • Carriageway and footway resurfacing
  • New landscaping and tree plantings

Phase four - Old Wareham Road roundabout to Mannings Heath mini roundabouts

Work on this section commenced on 20 October 2025 and is anticipated to complete by summer 2026. The majority of work will be carried out under minor carriageway incursion only, however there will be some off-peak/night working under temporary traffic lights required.

Work is being carried out in phases. Our contractor, M Group Highways, will keep businesses and residents up to date as works progress.

Final surfacing works for this section will not take place until the very end of the works, and we will write to affected residents and businesses with more information about the surfacing works and associated traffic management at that time.

The following sustainable travel improvements will be constructed between Old Wareham Road roundabout and Mannings Heath mini roundabouts:

  • New southbound bus lane from Mannings Heath mini roundabouts to Old Wareham Road roundabout
  • Two-way cycle track on the eastern side from Mannings Heath mini roundabouts to just north of Old Wareham Road roundabout – connecting into the cycle track already delivered to the north and south
  • New shared use path around Old Wareham Road roundabout, and up to No 558 on the western side
  • New toucan crossing on Old Wareham Road outside Nos 12/14 and 526 Ringwood Road
  • New toucan crossing outside No 524 and 329a/335 Ringwood Road
  • Realignment of the uncontrolled crossing on the northern arm of Old Wareham Road roundabout
  • New toucan crossing outside No 558 Ringwood Road (upgraded from a pedestrian refuge)
  • Crossing on Herbert Avenue (near Manor Avenue) to be relocated towards Mannings Heath mini roundabouts, opposite the car dealership
  • Existing staggered crossing point north of Mannings Heath mini roundabouts to be widened and upgraded to a toucan crossing
  • Upgrading the bus stop to a bus shelter at No 548 Ringwood Road
  • Removal of dedicated right turn into Rossmore Road – northbound carriageway will be widened to accommodate turning traffic, allowing northbound traffic to pass vehicles waiting to turn right
  • Side road junction improvements
  • Carriageway and footway resurfacing
  • New landscaping and tree planting
  • Banned right turn into St George Ave is to be maintained

It is currently anticipated that the works to Old Wareham Road roundabout will be carried out towards the latter stages of this phase.

Traffic Regulation Orders (TROs)

Full details of the traffic regulation order process and outcomes for these improvements are available here.

The improvements require changes to parking, with double yellow lines being introduced outside the following property numbers:

  • 142 – 160 Ringwood Road
  • 182- 200 Ringwood Road
  • 206 – 232 Ringwood Road
  • 244 - 252 Ringwood Road
  • 47 – 59 Ringwood Road, and up to the bus stop on the eastern side

This will result in the removal of approximately 30 parking spaces (using BCP Council’s standard measure for parking lengths).

The introduction of these parking restrictions was subject to the outcome of a separate legal process. We invited comments on the proposed Traffic Regulation Orders (TROs) earlier in June 2022 and the TRO was recommended for approval in October 2022. Full details of the traffic regulation order process and outcomes.

Surveys were undertaken reviewing the parking levels in the area, over one week in April 2021 and 2022, at the same morning, lunchtime, and evening periods. The average occupancy across all roads surveyed was 47% in April 2021, and 45% in April 2022. These results suggest that there is available parking in adjacent and nearby roads to accommodate the loss of the parking spaces. View the results.

Public consultation

Public consultation on these proposals was undertaken May – June 2021. For the consultation, the proposals were split into three sub-sections: (Fernside Road – Sea View Road; Sea View Road – Mannings Heath mini roundabouts; Mannings Heath mini roundabouts – Mountbatten roundabout).

All responses were analysed and helped shape the final scheme designs. Reports summarising the results of the consultation are available here:

A report detailing our responses to issues raised is available here.

A public information event about the proposals was held on 8 June 2022.
